To-Do's after PV Assisted Setup

Summary

This article outlines the checklist and necessary modifications after completing the PrintVis Assisted Setup. Ensure all items are addressed before performing initial tests.

BC / PrintVis (with BC Partner)

  • No. Series
  • Verify and configure series for Quote and Order in PV General Setup.

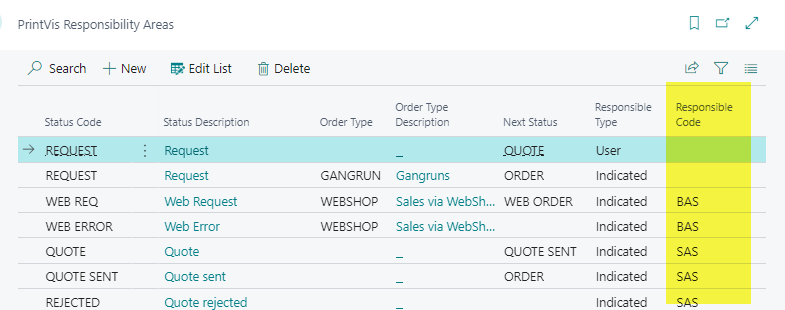

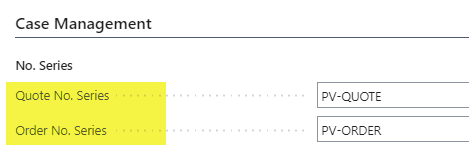

To-Do's after PV Assisted Setup 1.jpg

  • PV G/L Posting Setup
  • Ensure the General Ledger Posting Setup is correctly configured.

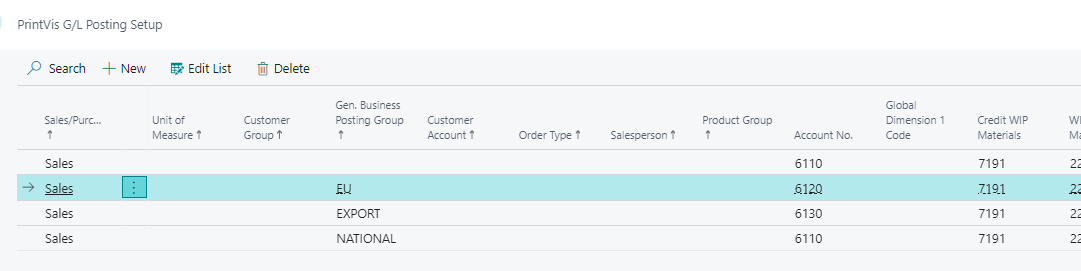

To-Do's after PV Assisted Setup 2.jpg

PV Workflow / User

  • Set up workflows and assign users.
  • Capacity Resources – Teams

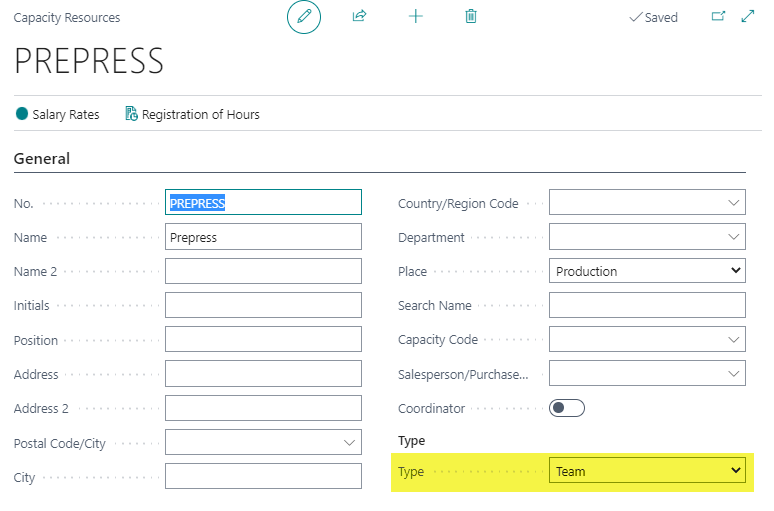

    • Check and configure capacity resources and team assignments.

To-Do's after PV Assisted Setup 3.jpg

  • Responsibility Areas
  • Address any missing users or teams and assign the Responsible Code.

To-Do's after PV Assisted Setup 4.jpg

  • User Setup
  • Add the Team Code to the Responsibility Area for each user.

To-Do's after PV Assisted Setup 5.jpg

  • Check User Permission Setup
  • Verify user permissions and access levels.

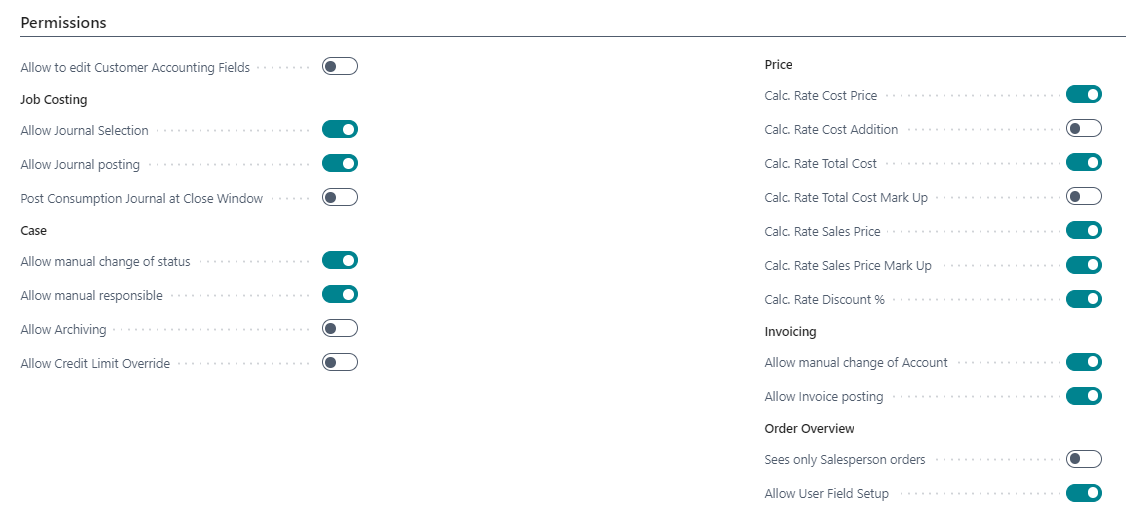

To-Do's after PV Assisted Setup 6.jpg

Production

  • Cost Center
  • Configure the Shop Floor Production Plan Tile Setup.

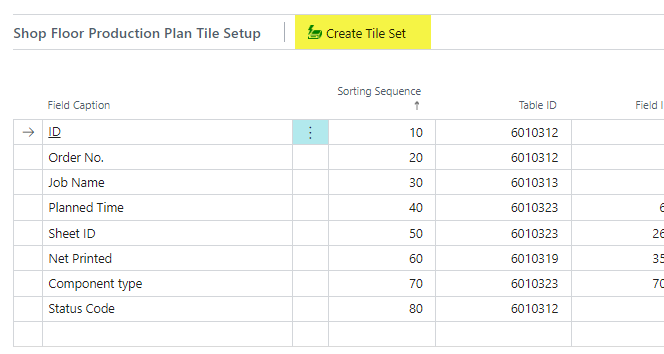

To-Do's after PV Assisted Setup 7.jpg

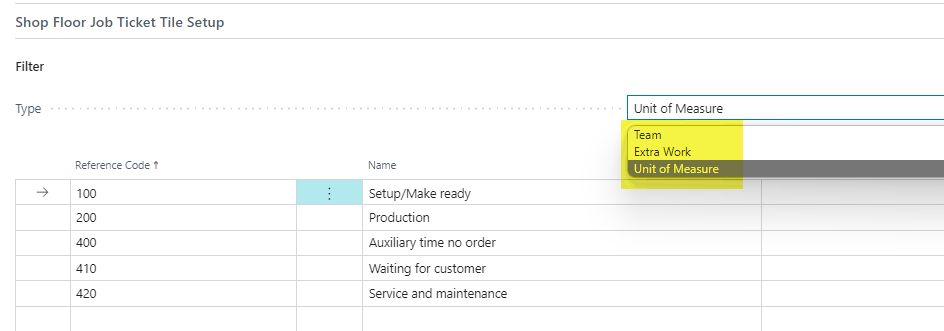

  • Set up the Shop Floor Job Ticket Tile (Teams, Extra Work, Unit of Measure).

To-Do's after PV Assisted Setup 8.jpg

Estimation

  • Calculation Units
  • Add any missing items to Calculation Units.

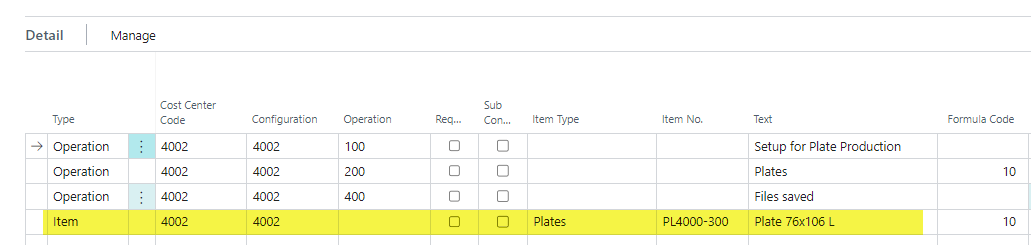

To-Do's after PV Assisted Setup 9.jpg

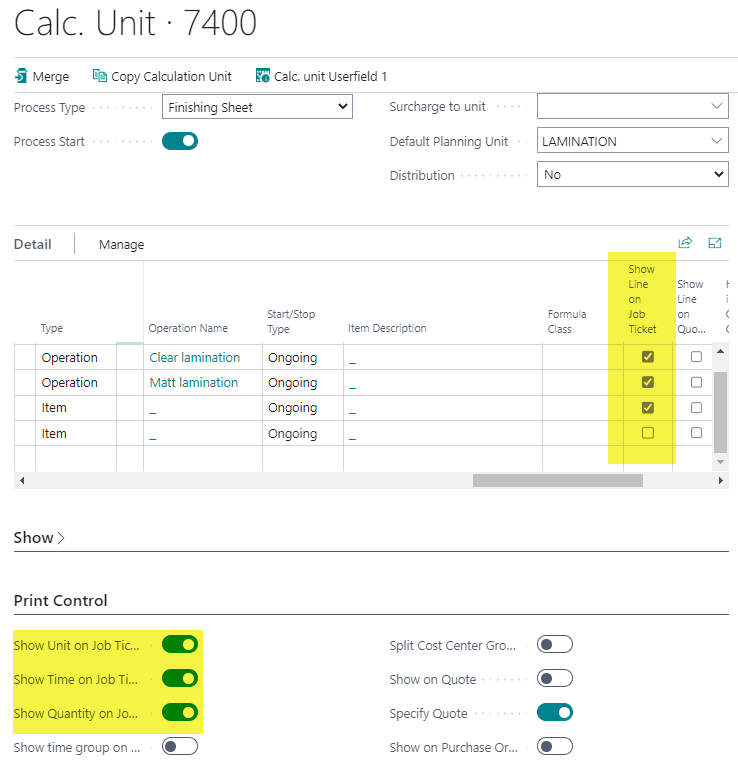

  • Verify "Show Line in Job Ticket" and configure FastTab Print Control.

To-Do's after PV Assisted Setup 10.jpg

  • Product Groups
  • Ensure proper filtering for Item Type Code / Lookup.

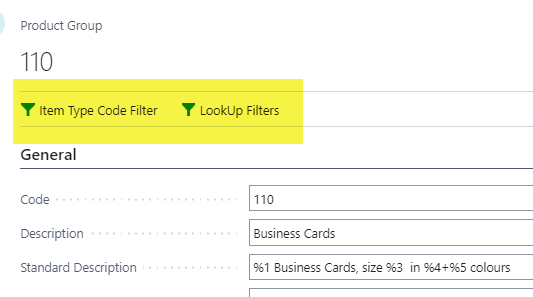

To-Do's after PV Assisted Setup 11.jpg

  • Item Qualities
  • Confirm the setup for Purchase Management.

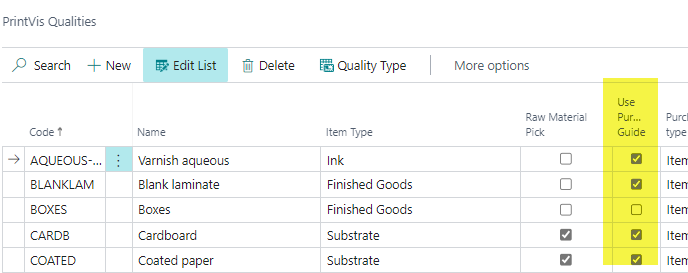

To-Do's after PV Assisted Setup 12.jpg

Planning Setup

  • Capacity Units
  • Standard Setup:

To-Do's after PV Assisted Setup 13.jpg

- Time Rounding (e.g., 00:15:00).
- Efficiency Planning Unit (real possible working time).
- Minimum Split Time for auto-splitting.
- Shop Floor Prod. Sorting = Planning Unit Priority.

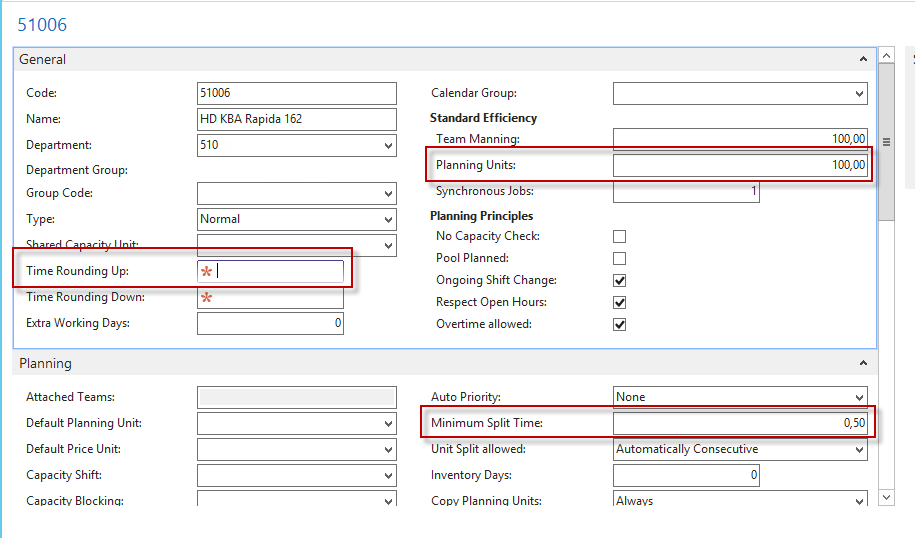

To-Do's after PV Assisted Setup 14.jpg

  • Group Code
    • Set up Group Code for planning filters.

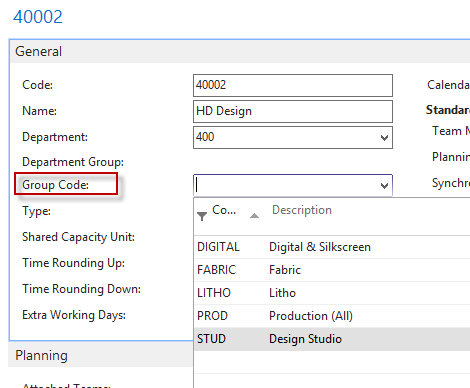

To-Do's after PV Assisted Setup 15.jpg

  • Setup for Same Machines
    • Ensure consistent setup so orders can be moved between machines.

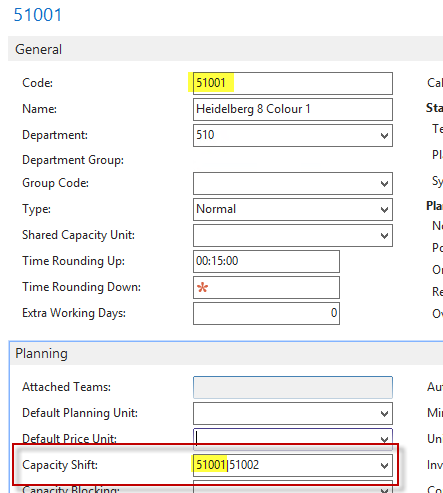

To-Do's after PV Assisted Setup 16.jpg

  • Planning Units
  • Delete all “Lists - Calculation Units” from the Planning Units.
  • Remove any Units that should not be planned.

Optional Setup

  • Q/A Setup
  • Configure Quality Assurance settings.

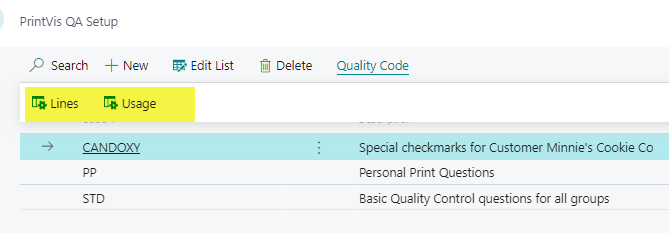

To-Do's after PV Assisted Setup 17.jpg

  • Commission Rates
  • Set up commission rates for sales.

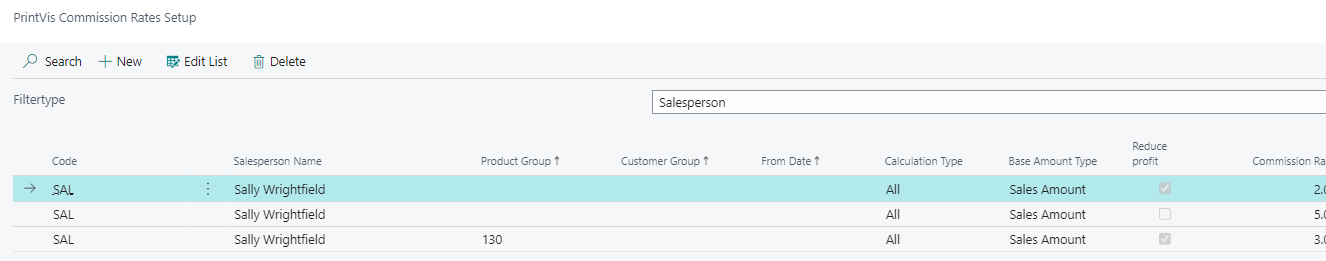

To-Do's after PV Assisted Setup 18.jpg

  • Customer Groups
  • Define and configure customer groups.

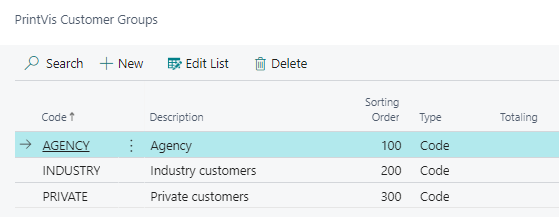

To-Do's after PV Assisted Setup 19.jpg

  • Complaint Reasons
  • Set up reasons for customer complaints.

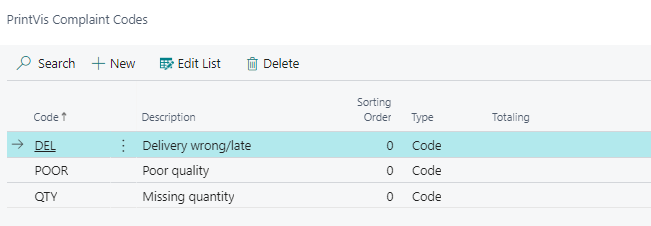

To-Do's after PV Assisted Setup 20.jpg

  • Rejection Codes
  • Configure rejection codes.

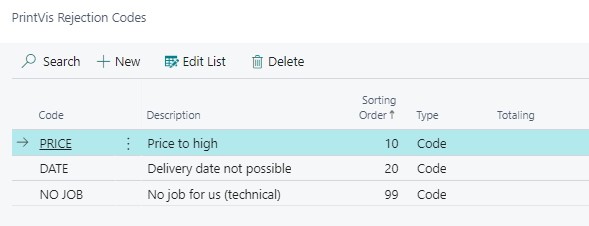

To-Do's after PV Assisted Setup 21.jpg

  • Discount Groups
  • Establish discount groups.

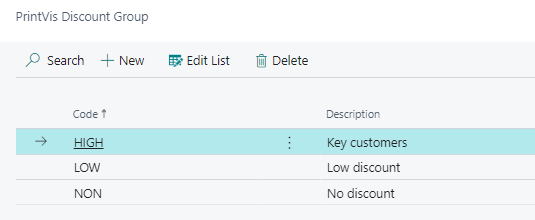

To-Do's after PV Assisted Setup 22.jpg

  • Rates of Discount

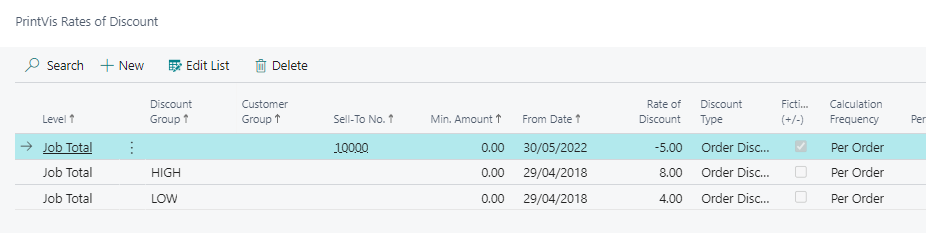

  • Define discount rates.

To-Do's after PV Assisted Setup 23.jpg
